Three Decisions I Made Differently Once I Had Trusted Discovery Data
CIO decisions on vendor consolidation, cloud migration, and change approvals depend on accurate data about the infrastructure being changed. When that data comes from a manually maintained CMDB rather than a live discovery scan, the gap between the record and reality routinely runs 20–40% — enough to shift project budgets, timelines, and change windows by a material margin. These are three decisions that went differently once discovery-sourced data — infrastructure state pulled directly from live scan output, with an explicit timestamp — replaced the CMDB as the authoritative input.
Most CIOs I know do not think of data quality as a decision-making problem. They think of it as an IT operations problem — something the infrastructure team handles, something that shows up in audit reports, something that matters for compliance. The CMDB data behind a vendor decision, a migration timeline, or a change window approval might be structurally wrong in ways that change the outcome. Most CIOs don’t register that risk until it happens to them.
It happened to me three times in close succession. The third time, I had current infrastructure data behind the decision instead of a CMDB record that had not been validated in months. That third decision went differently from the first two.

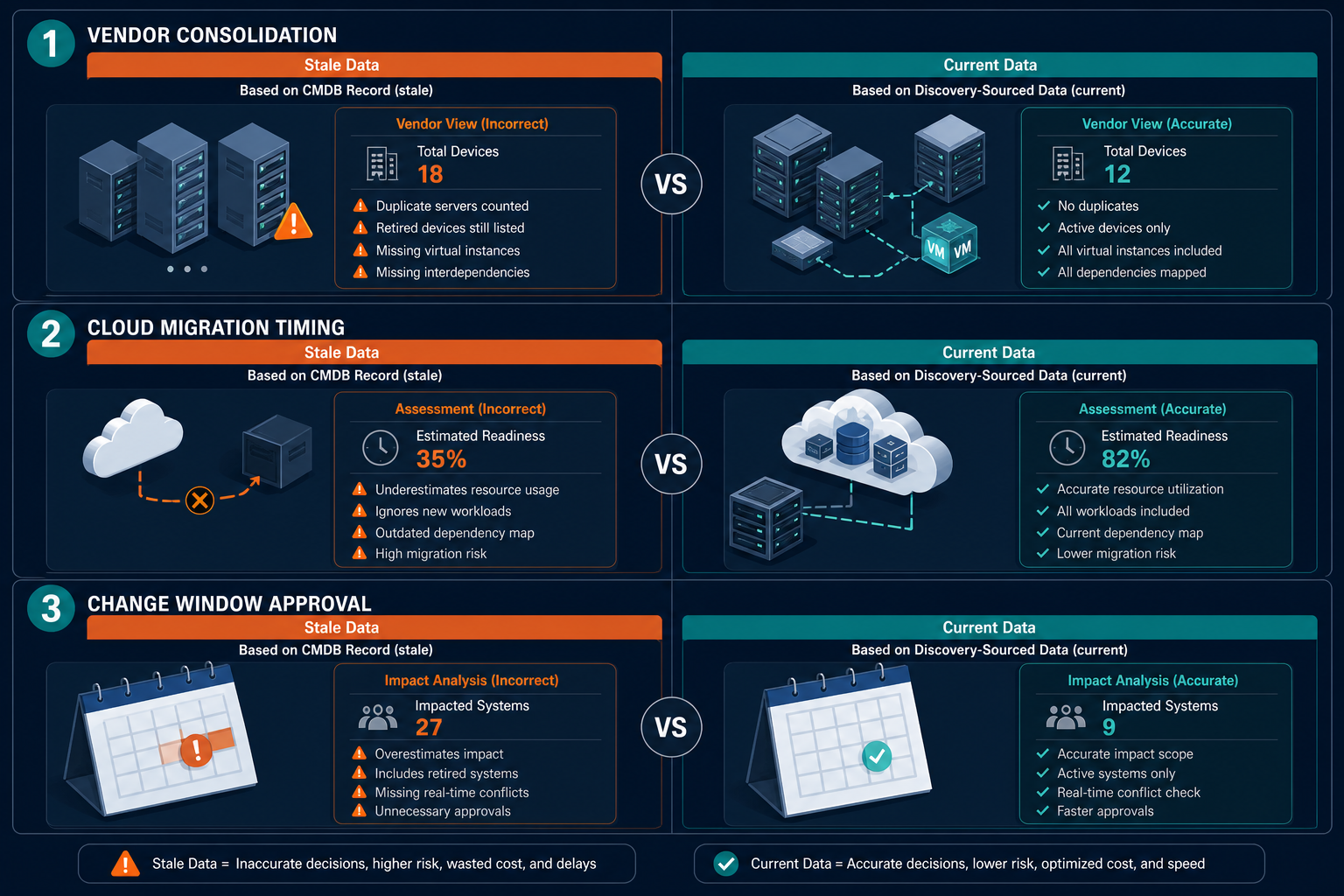

Decision One: Vendor Consolidation and CMDB Data Gaps — The $340,000 Difference
In the first major vendor consolidation review I oversaw, my infrastructure team pulled a CMDB report showing 340 devices running the endpoint management agent from a vendor we were planning to decommission. The migration budget was scoped around that number: contract termination, agent removal, transition testing, and parallel run. Total approved budget: $1.4M.
Three months into the project, a senior engineer ran a fresh agentless discovery scan across the affected infrastructure segments. The actual device count running the agent was 218. The 122 discrepancy represented devices that had been decommissioned over the prior two years without the CMDB being updated — phantom records that had been sitting in the register and were included in every report generated from it.
That scope contracted. So migration testing dropped from 340 to 218 devices. The parallel run period shortened. The final project cost came in at $1.06M — $340,000 below the approved budget.
That budget reduction was not a win I could take credit for. The $340,000 of unnecessary scope had been in the plan from the beginning. Discovery surfaced it before we paid for it, not after.
| How does discovery-sourced data change IT vendor consolidation decisions? |
|---|
| Discovery scans identify actual devices in the environment versus CMDB records that may include decommissioned, phantom, or undocumented assets. For vendor consolidation decisions, the delta between the CMDB count and the discovery count determines the true scope, and frequently the true cost, of the migration. Projects scoped on stale CMDB data routinely overestimate or underestimate scope by 20–40% (Virima analysis). |

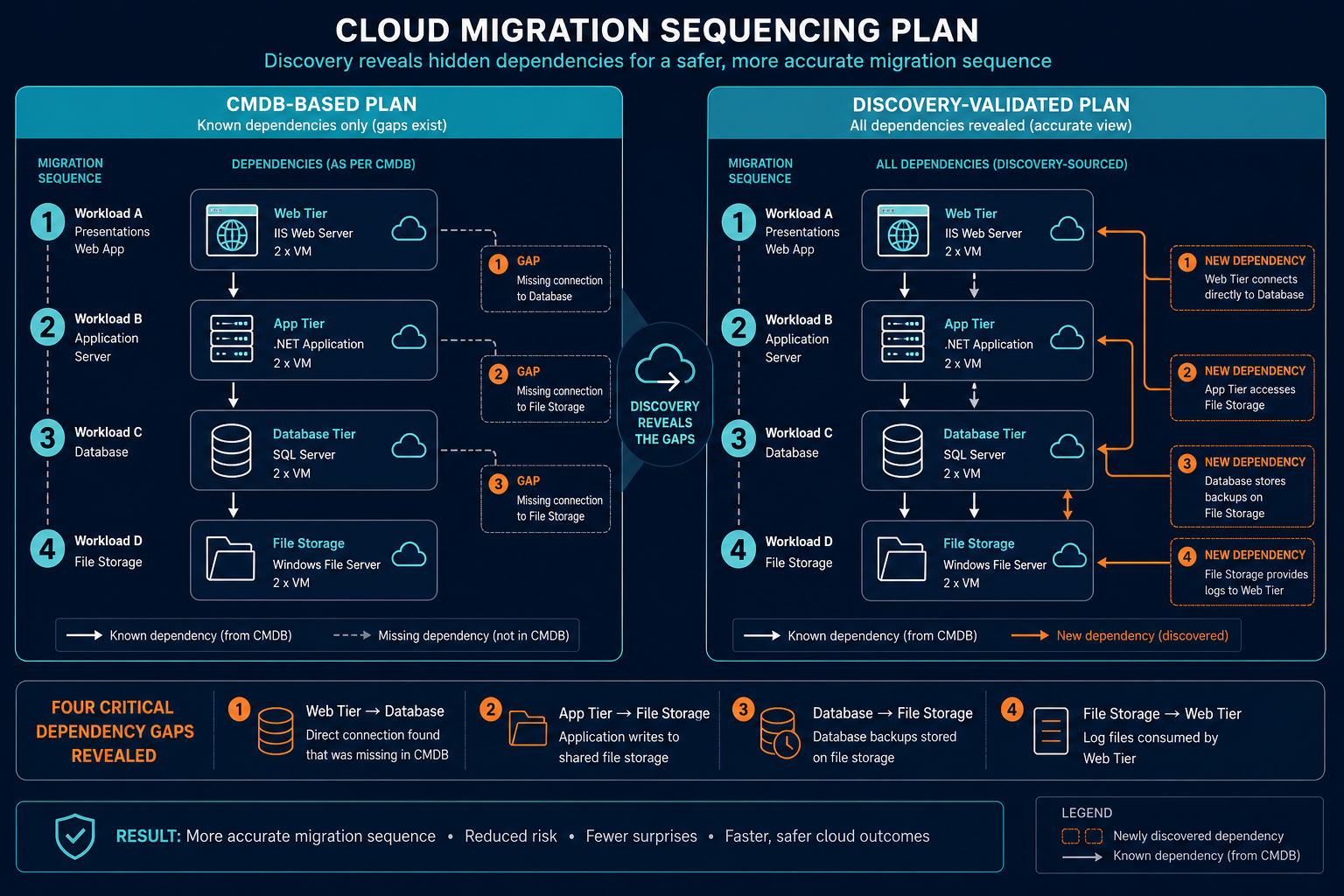

Decision Two: Cloud Migration Timeline — 18 Months Instead of 12
The board approved a cloud migration strategy targeting 60% workload migration within 12 months. The target was aggressive but defensible, based on a dependency map I had compiled from Confluence, architecture reviews, and the CMDB — showing our top 30 workloads with their interdependencies.
Before we finalized the migration sequencing, I asked for a discovery-sourced dependency validation of the top 10 workloads. I had learned from the vendor consolidation experience that CMDB records and reality had a gap, and I wanted to know the size of the gap before committing the timeline to the board.
The discovery validation found four undocumented interdependencies. Four dependency classes to validate before finalizing migration sequencing:
- A reporting workload planned for month 4 had a dependency on an on-premises data warehouse. The architecture documents marked it “scheduled for decommission” — but it was actively serving 14 applications with no confirmed decommission date.
- A customer portal application marked as cloud-ready had 11 hardcoded references to on-premises IP addresses in its configuration layer, none of which appeared in the documented architecture.
- Two workloads in the month-7 migration batch had bidirectional dependencies on each other that had not been captured in the dependency data — migrating them in the planned sequence would have broken both.
- A batch processing service used by finance had a dependency on a vendor-managed system with a contractual on-premises hosting requirement through month 16.
Migrating those four workloads in the planned sequence would have triggered failures requiring a full stop. The board would have seen a program failure within 90 days.


I went back to the board with a revised timeline: 18 months instead of 12, with an explanation of the four interdependency issues that the discovery validation had surfaced. The board approved the revision. The migration completed on the 18-month schedule with no major incidents.
Research estimates that 60–70% of cloud migration delays trace back to dependency gaps not caught before sequencing. My experience confirmed that range exactly.
Decision Three: Change Window — A Saturday Turned Into a 3-Day Maintenance
The change involved replacing a storage array serving a segment of the data center. The CMDB showed 47 dependent systems. A Saturday maintenance window with four hours of planned downtime was approved by the change advisory board. All 47 system owners had been notified.
I had instituted a new policy six months earlier: before any tier-1 change window, run a fresh discovery scan of the affected infrastructure segment and compare against the CMDB dependency count. If the counts do not match within 10%, escalate to the change sponsor.
The pre-change discovery scan found 61 dependent systems. Fourteen had been deployed in the nine months since the CMDB had last been updated for that storage segment — all microservices built by product engineering teams that had not submitted CMDB update requests.
The change window was redesigned: from a four-hour Saturday window with 47 notified teams to a three-day planned maintenance with 61 notified teams, additional rollback testing for the 14 new microservices, and a dedicated communication to three application owners whose services had SLA commitments that required 72-hour advance notice.
Because Virima’s discovery runs continuously against defined infrastructure segments, the pre-change validation for this storage segment took hours rather than days — the current state was already indexed. That speed is what makes the policy practical at scale.
No production incident resulted from the change. Without the pre-change discovery refresh, 14 application teams would have lost storage access during a Saturday window with no advance notice and no rollback plan covering their systems.
| Why should a CIO require discovery validation before major change windows? |
|---|
| CMDB records of dependent systems are typically 20–40% incomplete in environments with active development cycles (Virima analysis). A change window scoped for 47 notified systems that actually affects 61 creates 14 unplanned outages affecting teams who were never told the change was happening. Pre-change discovery validation identifies that gap before the change executes rather than after. |
The Pattern Across All Three Decisions
All three decisions share the same pattern: CMDB records accurately described the past. Discovery-sourced ground truth described the present. In each case, the decision I needed to make was about the present.
The vendor consolidation budget was based on a device count that was accurate in 2022 but not in 2024. The migration timeline was based on dependency data that was accurate when the architecture was designed but not when the migration was ready to execute. The change window was scoped against a dependent-system list that was accurate before 14 new microservices were deployed without CMDB entries. CMDB data drift — the gap that accumulates from undocumented deployments, decommissions, and configuration changes — is what made each of those records wrong.
Why the gap between CMDB records and reality is a common state
This is not an edge case. A Forrester study (via Flexera, 2024) found that fewer than half of IT leaders trust the data in their CMDB and CSDM enough to align products or automate processes on it. The gap between documentation and discovery is not a team-by-team anomaly — it is a common state in environments with active development cycles. CIOs tracking infrastructure health from discovery-sourced data will find this overview of CIO IT service health dashboards useful for the metrics that matter.
The same pattern holds for compliance reviews. CMDB records that miscount active systems by 15–30% surface as audit findings — and finding that gap during an audit, rather than before it, is the most expensive version of this problem. A discovery scan run before audit preparation converts a potential audit finding into a planned remediation.
Trusted Runtime Truth is a decision quality standard, not an infrastructure one. The standard requires that data behind a decision reflect current infrastructure state, with an explicit discovery source and timestamp. The three decisions I described above either avoided significant cost or avoided production incidents because the data behind them was discovery-sourced, not documentation-sourced.
For CIOs building this capability, the starting point is not a CMDB replacement project. It is discovery scope and freshness thresholds — how often each infrastructure segment is scanned, and how that frequency is matched to the decision cadence of the teams that depend on it.
| What is the relationship between IT discovery frequency and decision quality for CIOs? |
|---|
| Discovery frequency determines how current the data is behind each decision. In environments with active development cycles, CMDB data drifts by 15–25% per quarter from undocumented deployments and decommissions (Virima analysis). A CIO making vendor, migration, or change decisions on CMDB data more than 60–90 days old is effectively making decisions on last quarter’s infrastructure — which may differ materially from this quarter’s. |
